Public Meeting Presentation
U²C Phase II – Skyway Rehabilitation & Downtown Service Expansion PD&E Study
Watch the public meeting presentation that was displayed at the public meetings.
Doubletree Jacksonville Riverfront
1201 Riverplace Boulevard
FSCJ Advanced Technology Center
401 West State Street
The Jessie (Jessie Ball duPont Center)
40 East Adams Street
Ashley Square
650 North Newnan Street
The Ultimate Urban Circulator Program, or the U²C Program, is the JTA’s plan to modernize the Skyway and connect the neighborhoods across downtown and nearby neighborhoods. Developed in three phases, the program is currently in Phase II, where we consider downtown service expansion. The Project Development and Environment (PD&E) study, where we look at options, or “alternatives,” to improve the system is now under development. Six “Build” alternatives plus a “No Build” option are being considered (see details inside). With your input, we will identify a Preferred Alternative to recommend to the JTA Board later this year.

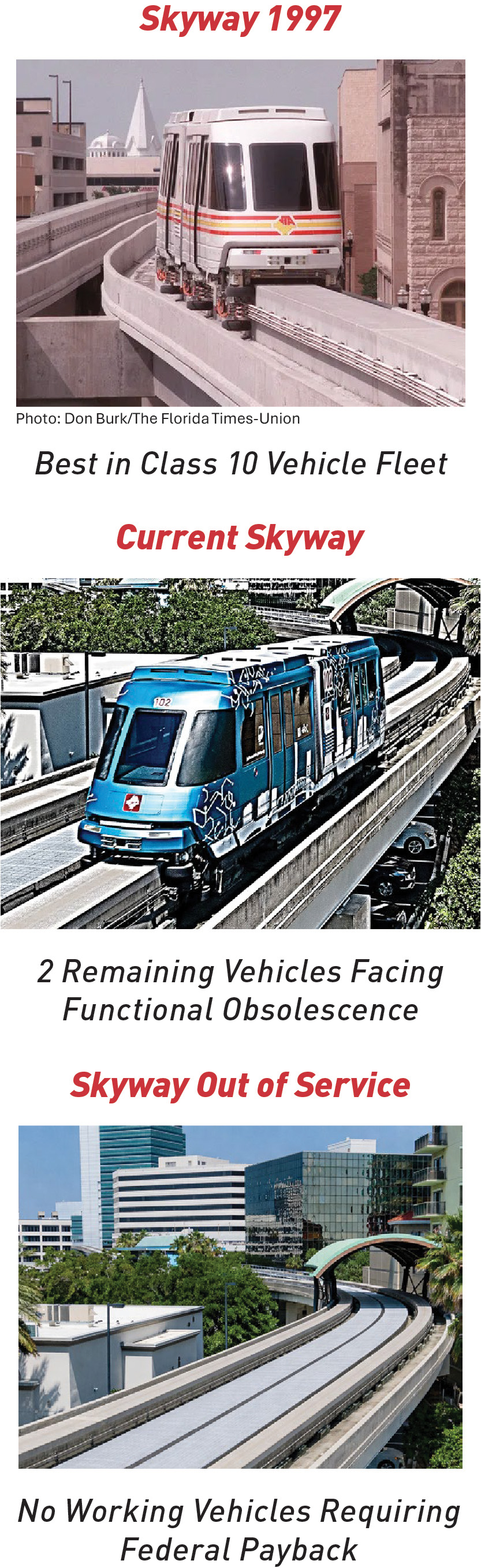

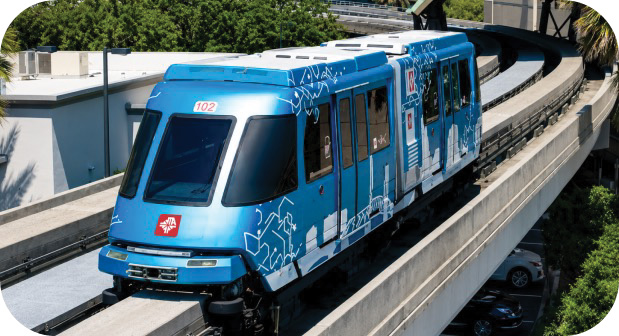

The No Build option keeps the Skyway system operating as it does today with the last two remaining vehicles. The existing track, vehicles, and automated train control system remain in use with required track repairs to maintain basic service for as long as possible.
Continues current operations with minimal disruption
System nearing end of life
Ongoing repairs required
Planning level cost estimate: $15 million

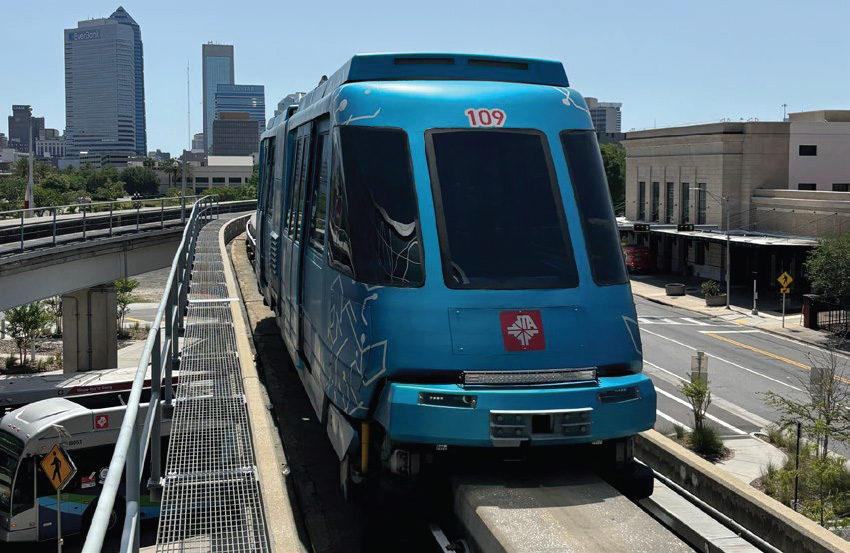

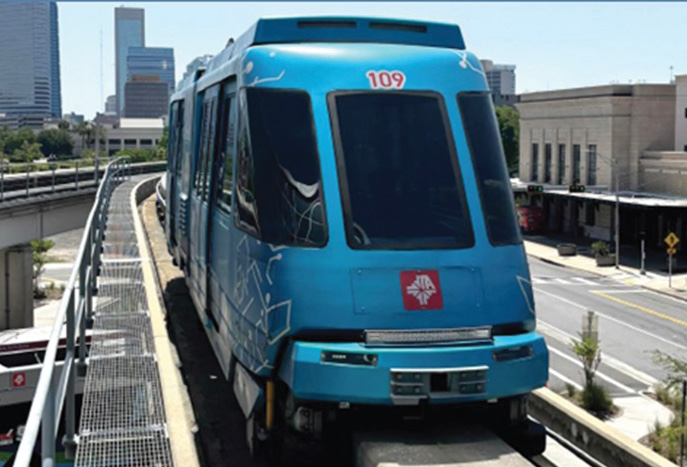

Alternative 1 keeps the Skyway system operating as it does today with a rehabilitated vehicle fleet of up to 10 cars. The existing track remains in use with a new automated train control system. Repairs will be made to the existing track to maintain current service. This investment improves system efficiency and overall passenger experience.
Headways up to 10 minutes or better
2-3 years of construction
Provides limited connectivity or support for future growth
Planning level cost estimate: $276 million
Alternative 2 replaces the current Skyway system with a new fleet of APM trains comparable to those deployed at U.S. airports. This alternative represents a full system modernization with new trains on the existing Skyway infrastructure, plus a new Brooklyn Station. It improves rider experience by providing a reliable, modern system.
Headways up to 10 minutes or better
3-4 years of construction
Provides additional connectivity with limited support for growth
Planning level cost estimate: $428 million

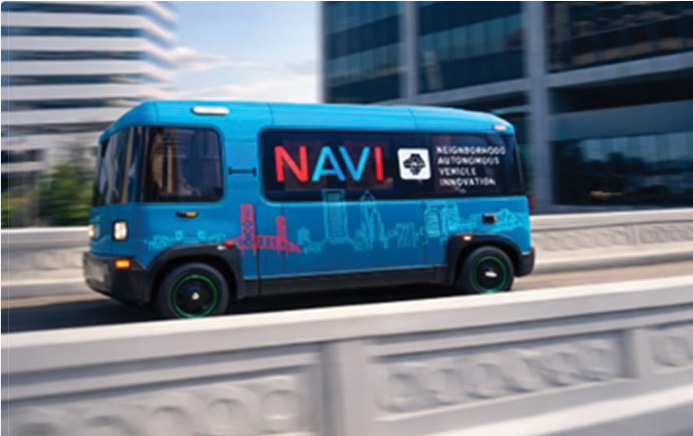

Alternative 3 converts the Skyway guideway to a dedicated roadway for current and future AVs. New ramp connections will be provided to existing streets at Rosa Parks, Kings Avenue, and Leila Street in the Brooklyn area to allow AVs to travel beyond the downtown urban core.
Headways up to 5 minutes or better
3-4 years of construction
Expands neighborhood connectivity
Planning level cost estimate: $294 million

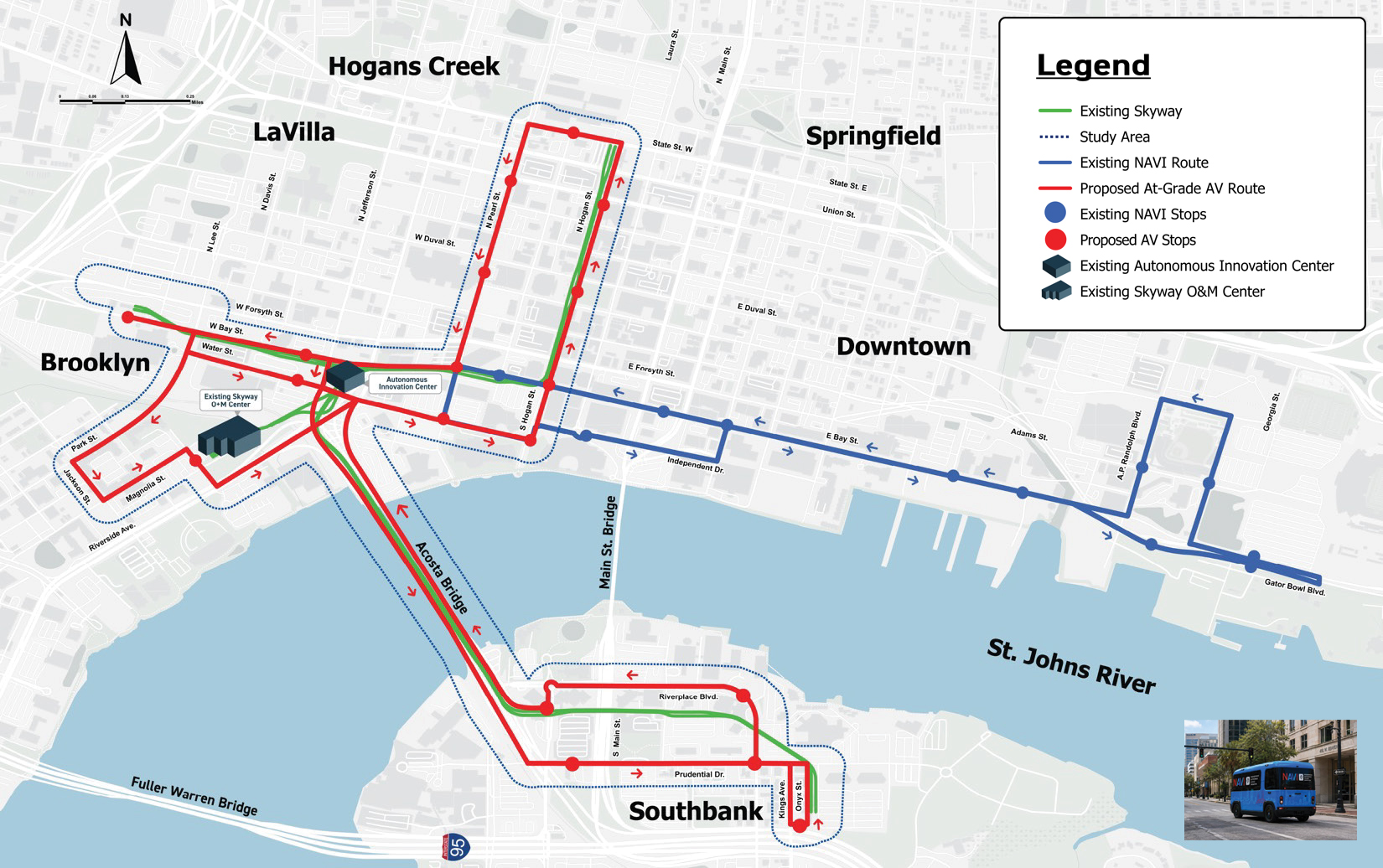

Alternative 4 removes the existing elevated Skyway and stations entirely, and 17 street-level stops will be constructed. AVs operate on existing downtown streets, converting service entirely to the roadway network. Key intersections along the corridor will be upgraded to incorporate transit signal priority. See the back for a map of the proposed AV route.
Headways up to 5 minutes or better
Use of dedicated lanes where feasible
Deployment of AVs independent of construction
2-3 years of construction
Provides flexibility for growth
Planning level cost estimate: $152 million

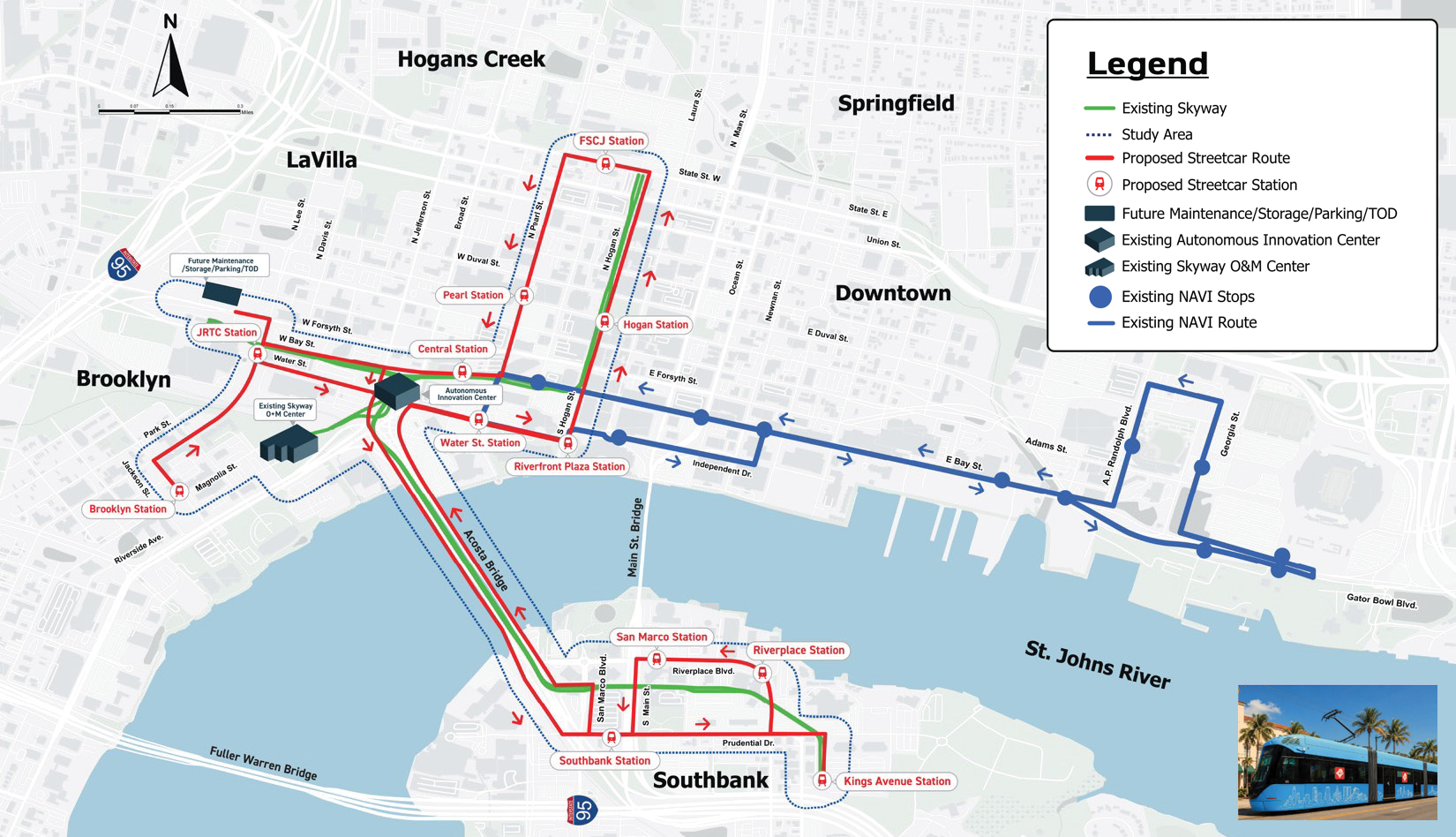

Alternative 6 replaces the Skyway system with a streetcar system at street level with 12 stations. The vehicle fleet consists of up to 12 streetcars. Key intersections will be upgraded to incorporate transit signal priority. This option supports transit-oriented development opportunities. See the back for a map of the proposed streetcar route.
Headways up to 10 minutes or better
4 years of construction
Provides flexibility for growth
Unknown Costs to Retrofit the Elevated Structure and for Dedicated Lanes
Planning level cost estimate: $565 million


A PD&E study is an environmental and engineering process that was developed by the Florida Department of Transportation (FDOT) in response to the National Environmental Policy Act (NEPA) of 1969. The process ensures that transportation projects are developed with consideration of current engineering standards, project costs, and minimization of social and environmental impacts, while involving the public throughout the entire study process.
The current Skyway system is over 35 years old and requires modernization to continue serving Jacksonville. This study evaluates how to rehabilitate the existing infrastructure while expanding service to meet downtown’s growing needs. We are evaluating “Build” alternatives against a “No Build” option to find the most cost-effective and impactful solution. With your input throughout the process, we will identify a Preferred Alternative to recommend to the JTA Board.

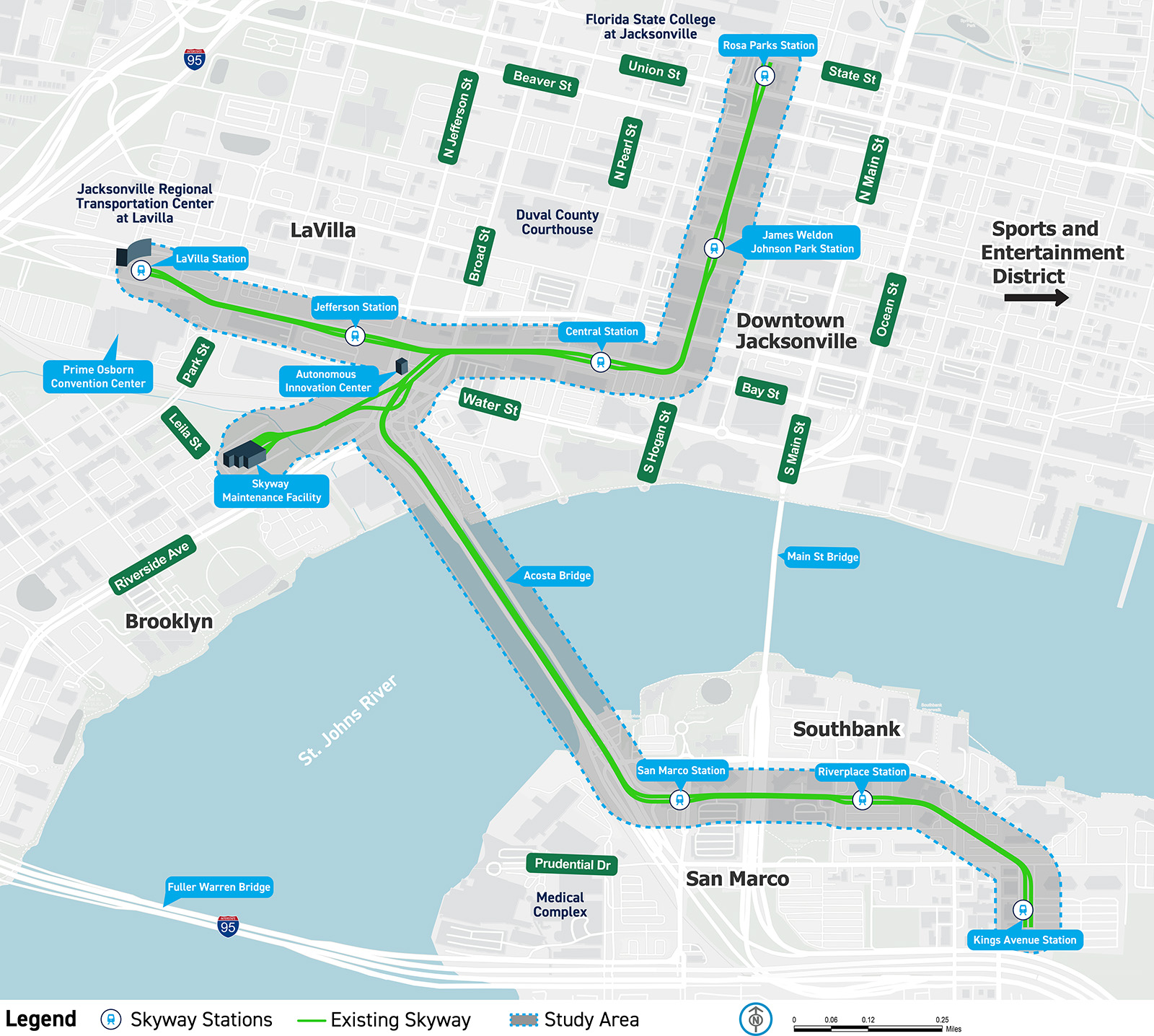

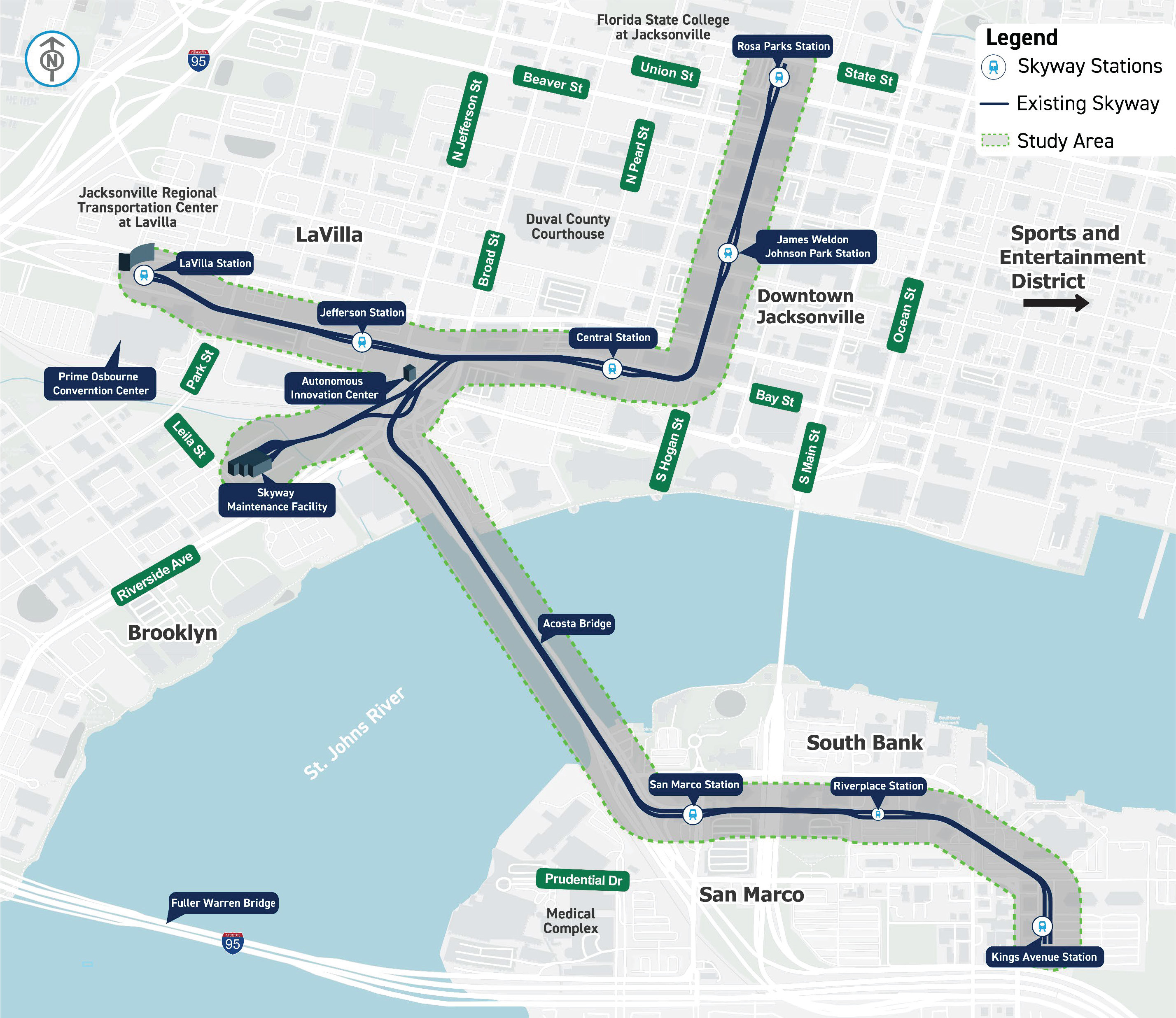

The project spans the full 2.5-mile extent of the current Skyway. To account for environmental considerations, future expansion, and multimodal integration the study area includes a 200-foot buffer zone measured from the centerline of the existing guideway.
